Automation

Control and safety systems, SCADA and plant data, programmed, tested and commissioned by I2R. One panel to plant-wide

ONE PANEL TO PLANT-WIDE
No job too small, none too large

6+ AUTOMATION ENGINEERS
On the desk and in the field

BRISBANE AND RIVERINA
Teams on the ground when the job needs them

Allen-Bradley Siemens Schneider Electric Omron
Rockwell Automation Silver System Integrator Inductive Automation Ignition Gold certified integrator
CODESYS AVEVA Plant SCADA, formerly CitectSCADA Schneider Electric ClearSCADA

Why automate with I2R

01

Standard AOIs and faceplates. One maintained library across your whole plant. Every motor, drive, valve and analogue behaves and reports the same way, so your maintenance crew learns it once.

02

Simulation before hardware. Sequences and interlocks run against a simulated process while the panel is still being wired. The faults surface at the desk, not on your plant floor.

03

100% QC before FAT. Reviewed by an engineer who did not write it, against a checklist that has to be complete before anything goes to factory testing. No exceptions, and yes, we are irritating about it.

04

Loop checks and tuning on site. When needed, we are on the plant for the cutover: point to point, sequence proving, process tuning alongside your operators, then the same people on the phone afterwards.

Standardisation

Built the same way, every time


It is the thing we are best at, and we apply it to ourselves first.

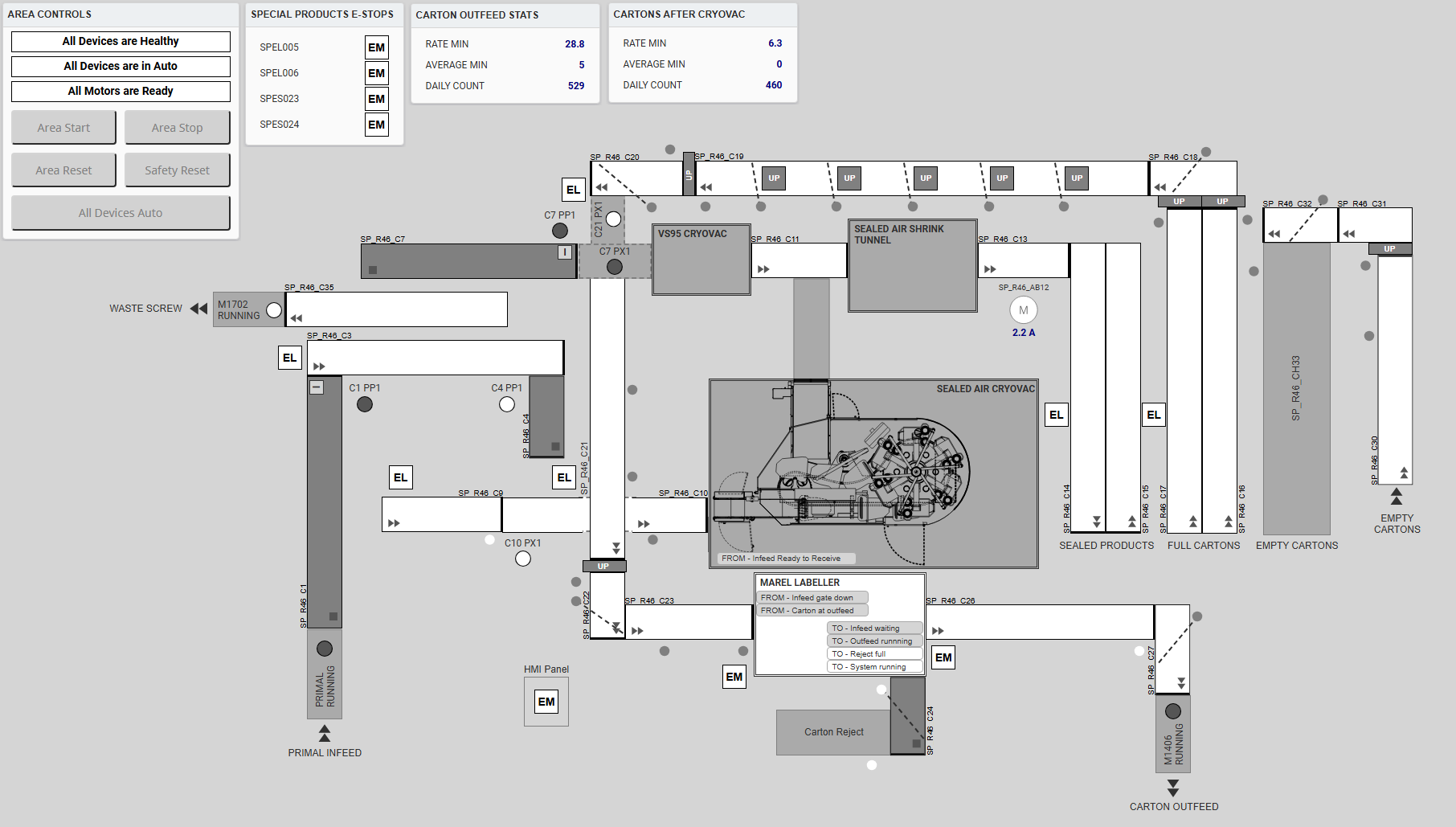

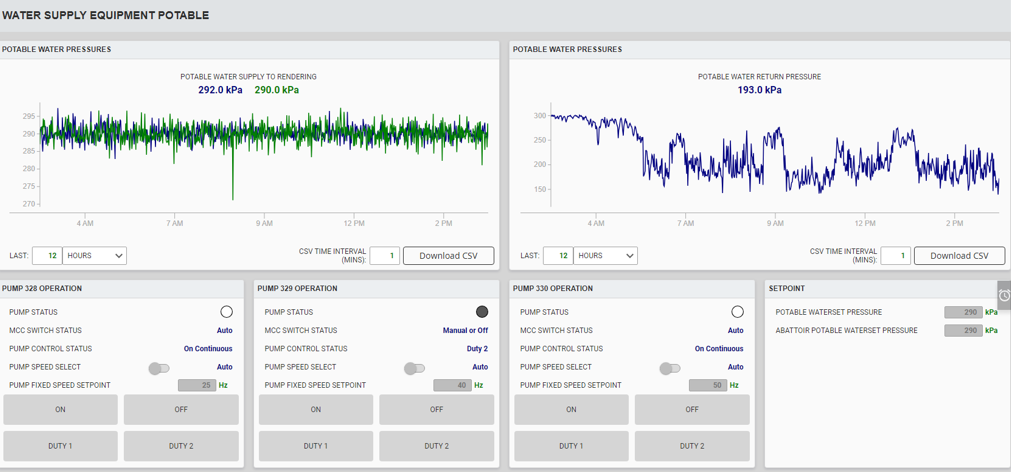

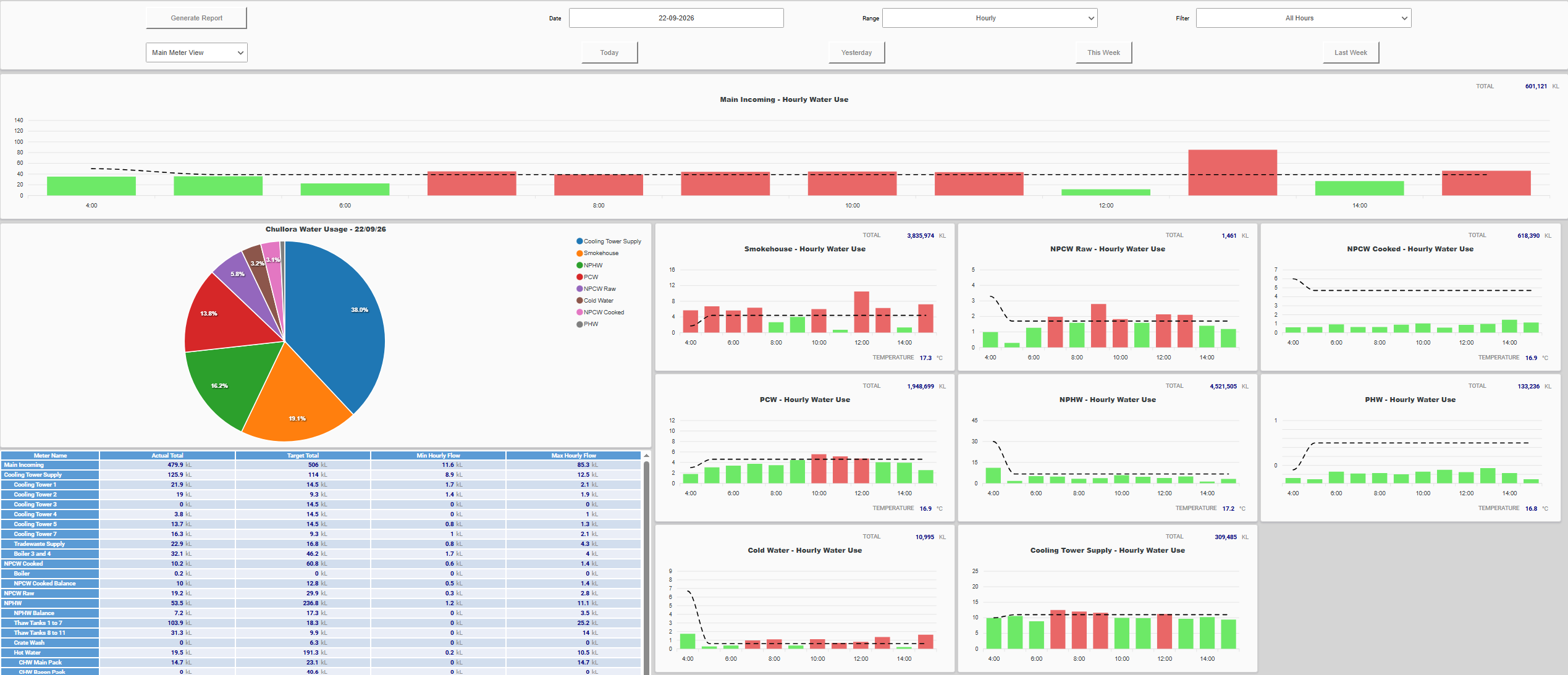

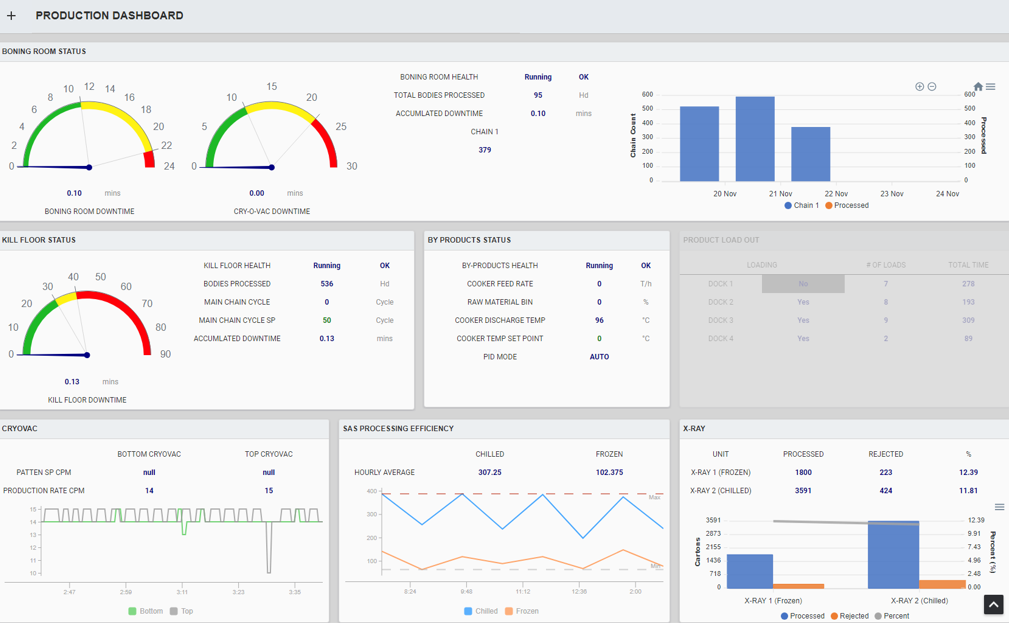

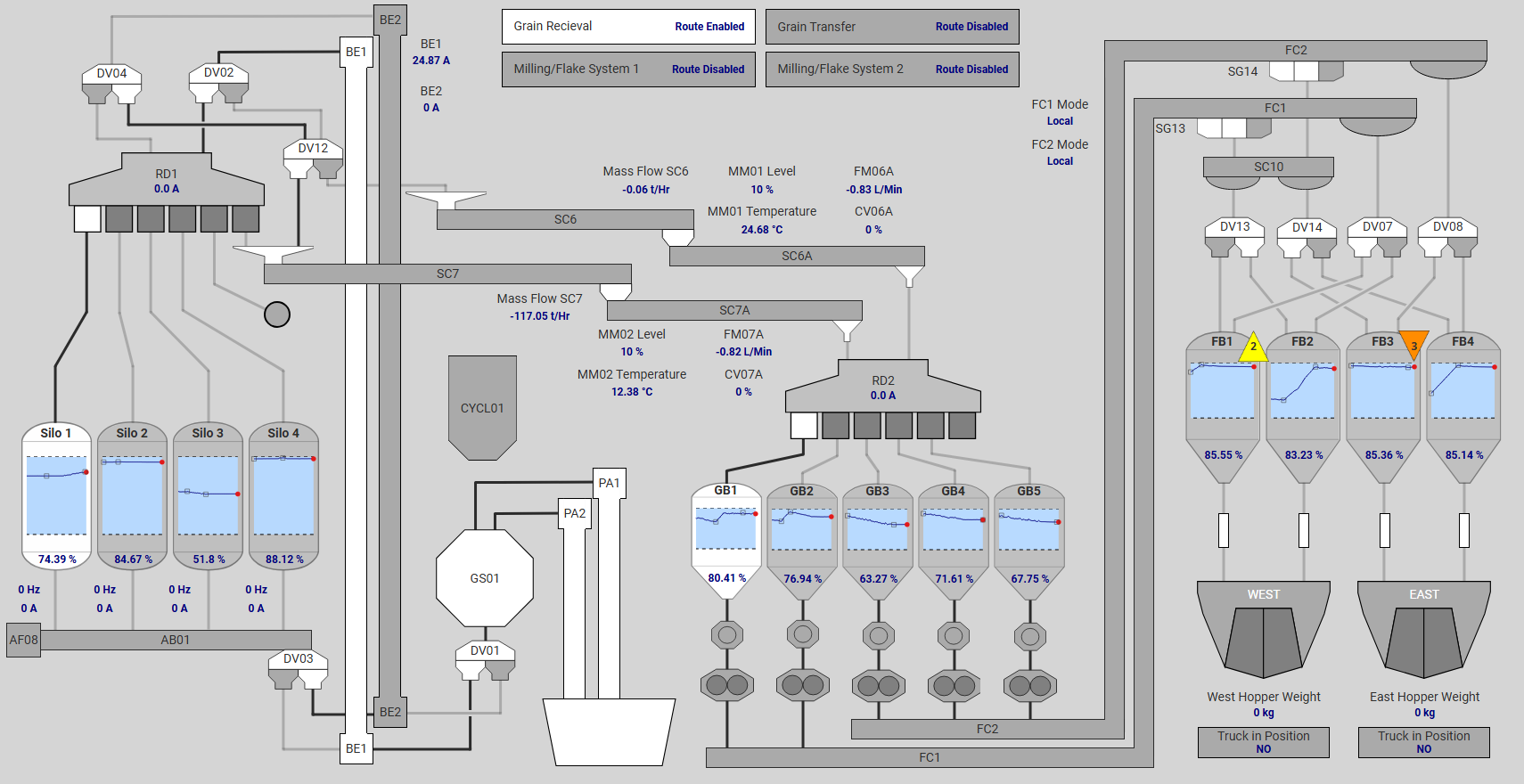

Every device on the plant running alongside this page came out of the same maintained library. Same faceplate, same status lines, same controls in the same positions, used twice or two hundred times.

Click any device on the plant Its faceplate opens below, live
SEQUENCE OVERVIEWCIP1, CLEAN IN PLACE
STEP20PREVIOUS10
TIME IN STEP31/180SECONDS
All Devices are HealthyAll Devices are in Auto
STEP CONDITIONSWaiting on TT1 above 65 °C

Simulated live  The sequence manager driving the plant alongside this page.

P1
DEVICE LOCATIONProcess Line 1
PLC TAGP1
DEVICE NAMETransfer Pump
INTERLOCK GENERAL SETTINGS DIAGNOSTICS ALARMS TREND
DESCRIPTIONSTATUSOVERRIDE
Suction valve openOKNo
Discharge valve openOKNo
Buffer tank above low levelOKNo
Local isolator closedOKNo
Emergency stop healthyOKNo
Drive readyOKNo
STATUS
StatusRUNNING
Control ModeAUTO
InterlocksOK
DirectionFORWARD
Current4.2 A
Run Hours464.3 Hrs
Speed Feedback70 %
Speed Reference70 %
CONTROLS
OFFManualAuto
StartStop
ForwardReverse
Alarm Reset
SETTINGS
Start delay1.0 Sec
Stop delay2.0 Sec
Fail to start delay5.0 Sec
Minimum speed20 %
Maximum speed100 %
Run hours warning8000 Hrs
DEVICE DIAGNOSTICS
Present Fault Code0
Fault DescriptionNone

Detailed description: no fault present. The drive reports ready and running in auto.

PRIORITYLABELSTATE
HighFailed to reach positionCleared
MediumInterlock not satisfiedCleared
DiagnosticDevice in simulationCleared

No active alarms on this device.

LAST 1 HOURS
1009080706050403020100
:00:10:20:30:40:50
MODEVALUE
XV1
DEVICE LOCATIONBuffer Tank 1
PLC TAGXV1
DEVICE NAMETank 1 Inlet Valve
GENERAL SETTINGS DIAGNOSTICS ALARMS TREND CONFIG
STATUS
StatusCLOSED
Control ModeAUTO
InterlocksOK
CONTROLS
ManualAuto
CloseOpen
Alarm Reset
SETTINGS
Open Position Confirm Delay2.0 Sec
Closed Position Confirm Delay2.0 Sec
Fail to open delay5.0 Sec
Failed to close Delay5.0 Sec
PULSE CLEAN SETTINGS
Pulse Count3
Pulse On Time1.0 Sec
Pulse Off Time2.0 Sec
DEVICE DIAGNOSTICS
Valve StateCLOSED
Failed to OpenFALSE
Failed to CloseFALSE
PRIORITYLABELSTATE
HighFailed to reach positionCleared
MediumInterlock not satisfiedCleared
DiagnosticDevice in simulationCleared

No active alarms on this device.

LAST 1 HOURS
1009080706050403020100
:00:10:20:30:40:50
MODEVALUE
CONFIG
Has Open FeedbackTRUE
Has Close FeedbackTRUE
Normally OpenFALSE
LT1
DEVICE LOCATIONBuffer Tank 1
PLC TAGLT1
DEVICE NAMELevel Transmitter
GENERAL CONFIG ALARMS TREND SETTINGS
STATUS
Current Value0.0
StatusNORMAL
Simulated Value0.0
CONTROLS
Alarm Reset
CONFIG
Device NameBuffer Tank Level
Engineering Unitsbar
Filter Time0.5 Sec
Raw Minimum0
Raw Maximum32767
Scaled Minimum0.0
Scaled Maximum10.0
PRIORITYLABELSTATE
HighFailed to reach positionCleared
MediumInterlock not satisfiedCleared
DiagnosticDevice in simulationCleared

No active alarms on this device.

LAST 1 HOURS
1009080706050403020100
:00:10:20:30:40:50
MODEVALUE
ALARMTHRESHOLDAUTO RESET DBON DELAY
Hi-Hi9.00.22.0
Hi8.00.22.0
Lo1.50.22.0
Lo-Lo0.50.22.0
Under Range-0.2N/A2.0
Over Range10.2N/AAs above

Out of range alarms share the same on delay and auto reset when the signal returns inside the scaled range.

Standard objects

A maintained, version controlled library. Used twice or two hundred times, the behaviour is identical.

Standard graphics

One faceplate and mimic standard, to high performance principles, so an operator moving between lines sees the same thing.

Standard delivery

The same process, the same quality checklist and the same factory acceptance test on every project.

Or your standard

If you hold a site standard we build to it, and tell you where it fights the platform before we start rather than afterwards.

Talk about standardising your plant Ours or yours. The outcome is the same: your team can work on any system in the plant.

What we build

SCADA and Plant Data

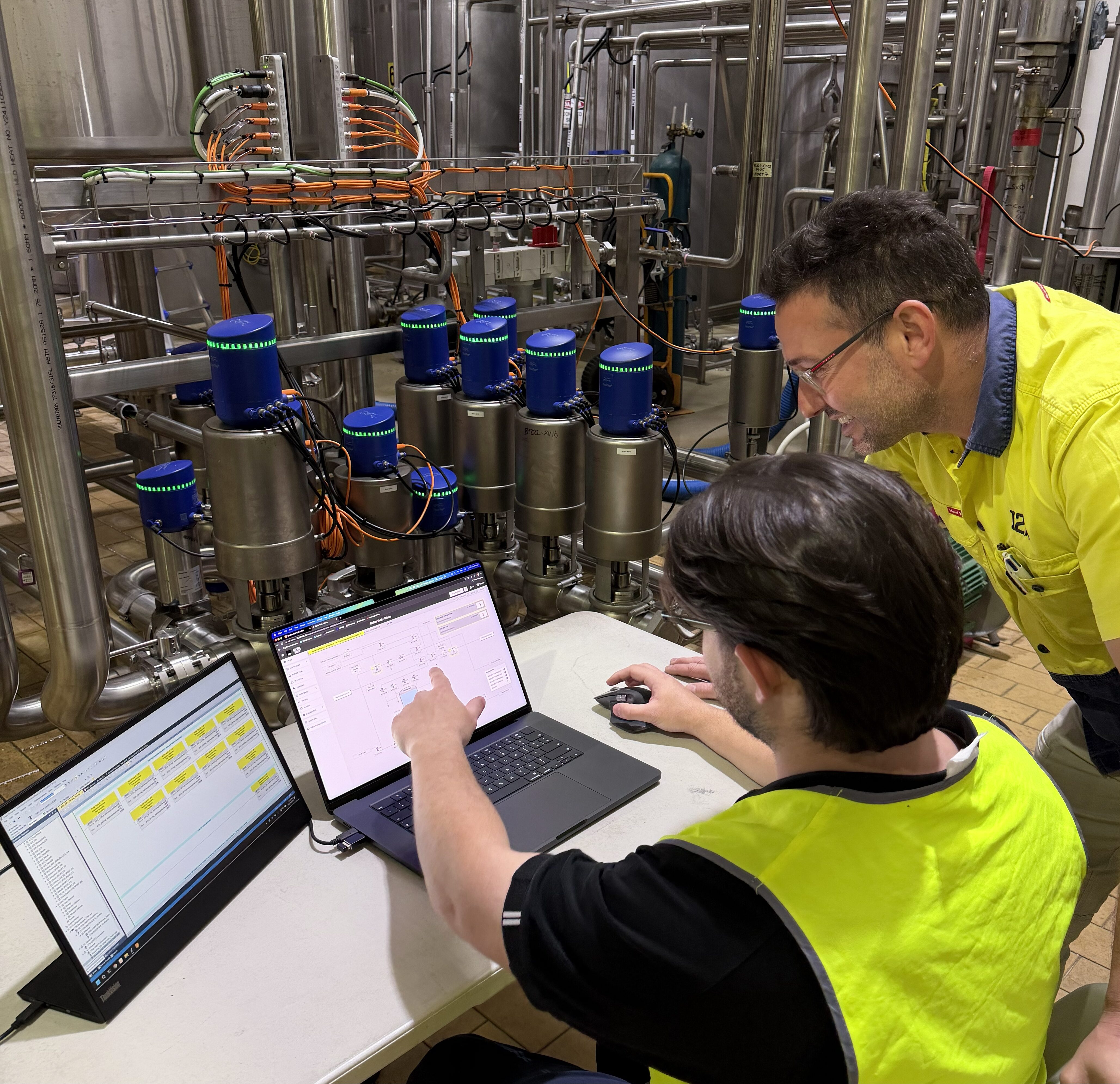

The plant running in the margins of this page is built the way we build yours.

Ignition Perspective, licensed by server rather than by seat, running in a browser and on a phone. One project serving the control room, the office and the plant floor. Where a site already runs FactoryTalk View, CitectSCADA or ClearSCADA we develop and support on that platform instead.

Automation » Automation » Automation » Automation » Automation »

Ignition Perspective

Ignition Edge

Ignition Vision

FactoryTalk View

CitectSCADA

ClearSCADA

Automation »

A new system, a rebuild of an old one, or an extension to what you already run.

What we build

CONTROL AND SAFETY SYSTEMS

Logix and GuardLogix applications built from our standard object library, tested against a simulated process before the hardware exists, and proven on an energised system before it reaches your plant.

Allen Bradley

Siemens

CODESYS

Schneider Electric

Omron

Pilz

IFM

B&R Automation

Mitsubishi Electric

Automation »
Automation » Automation » Automation » Automation »

Send a specification, an I/O schedule or a set of P&IDs. We come back with scope, exclusions and a price.

Services

Migration, Audit and support

Most plants are not greenfield. These three carry the brownfield work, on systems we built and on systems we did not.

01
Upgrades and migrations

SLC500, PLC-5 and MicroLogix onto Logix, reviewed line by line rather than run through a converter. Legacy SCADA rebuilt on Ignition with tag and historian continuity. Staged against your production calendar, with a tested rollback before anything is touched.

02
Automation and network audit

Every device on the control network mapped, the infrastructure tested, the control and SCADA layer reviewed, and costed options returned in a report you can take to your board. A paid engagement with a defined scope.

03
Support and fault response

Secure remote access to the sites we support, so we are in the controller and the SCADA while the fault is still being described. Teams in Brisbane and the Riverina when it needs people on site. Including systems we did not build.

Tell us what you run now, what it is doing, and your shutdown windows.

How a control system gets delivered


Verification at every stage on the bench, validation on the plant.

Six stages from approved design to a running process. The quality checklist has to be at 100% before factory acceptance testing, delivery is signed off before anyone travels, and the engineers who wrote the system are the ones on the floor at the cutover.

Stage 01

Design handover accepted

Delivery does not start on a verbal scope. It starts when the approved design is formally handed over and accepted, so what gets built is what was agreed, and a change is visible as a change.

  • The approved design is the input, not a moving target
  • Scope changes are recorded rather than absorbed
Stage 02

Quality plan and version control

The quality checklist for the project is raised before development, and every controller, HMI and SCADA change is version controlled from the first day. The tests are defined while the requirements are still fresh, not written up afterwards to suit what was built.

  • Quality checklist raised up front, from a standard template
  • Full change history, not a folder of dated backups
  • You get a current, restorable code set at handover
Stage 03

Development and simulation testing

Programming follows the approved design and the I2R standard objects, taken from the maintained library rather than written fresh each time. Sequences, interlocks and safety logic are tested against a simulated process while the hardware is still being built, and quality control runs alongside development rather than after it.

Development
Quality control
  • Standard objects first, written from scratch only where nothing fits
  • Simulation testing on every sequence and interlock before hardware exists
  • Faults found at the desk cost hours, the same fault on site costs a shutdown
Stage 04

Verification review and QC gate

The system is verified against the approved design by an engineer who did not write it, and the quality checklist has to be at 100% before it is allowed into factory acceptance testing. Where it helps, we walk you through the screens and the sequences first, so your feedback lands while changes are still cheap.

  • Independent verification against the design, progressive or final
  • 100% checklist is a gate into FAT, not a target
  • Client walkthrough before FAT when the project calls for it
Stage 05

Factory acceptance test

Validated against the design and the performance requirements on an energised system, to a standard test document, with I/O, drives, interlocks and safety functions proven point by point. You are welcome in the workshop for it, and the records are issued with the system.

  • Proves the build before it leaves us, not on your plant floor
  • Test records issued as a deliverable
Stage 06

Site acceptance, commissioning and support

The site acceptance test workbook is written before anyone travels, so site work is executed rather than improvised. Loop checks, sequence proving and process tuning are done on the plant with your operators, then the documentation, backups and code set are handed over and the same engineers support it.

  • SAT workbook written from the design, not from memory
  • Loop checks, sequence proving and process tuning on the plant
  • Delivery signed off, documentation and backups handed over, then remote support
